A.3 Pressurized Heavy Water Reactor (PHWR) Based  outlet  temperature monitoring  system (CTMS)  RTD
              NPPs                                               performance test etc.

           (i)  KAPP-3&4 and RAPP-7&8                               NPCIL submitted an application seeking permission
                                                                 for draining and drying of PHT System for KAPP-3 after
              Safety review of various submissions for the twin   completion  of PHT related commissioning  tests.  After
           units of 700 MWe PHWRs at Kakrapar, Gujarat (KAPP-    satisfactory review, permission for draining  of Light
           3&4) and  Rawatbhata, Rajasthan  (RAPP-7&8) is in     water from PHT system was granted on December 16,
           progress.  Review Groups in AERB are progressively    2019.
           reviewing  relevant  submissions on  Safety analyses,
           Stress analysis reports, Environmental  Qualification    In KAPP-4, civil construction  and  erection  of
           (EQ) reports,  Independent  Verification and Validation  equipment/  components  are under  progress. Pre-
           (IV&V) reports,  Commissioning  Procedures  for  both  stressing activity of  Unit-4 Inner Containment  was
           projects, Commissioning  reports  of KAPP-3 and  completed.
           Technical Specifications for Operation.
                                                                    As part of flood mitigation measures for KAPP-1
              NPCIL application  for authorization  of Primary  to 4, construction  of box culverts in  two of the three
           Heat Transport  (PHT) System  Hot  Conditioning  and  identified portions was completed and opened to public.
           Light Water Commissioning  (LWC) of KAPP-3  was  Lowering of adjacent ground surface to a specified level
           reviewed and clearance for KAPP-3 hot-conditioning  on both sides of box culvert is in progress. Process for
           and  associated  hot  tests was granted  on  August  07,  initiating the work of third portion is under progress.
           2019.

              Subsequently, NPCIL submitted an application for
           seeking permission for remaining LWC tests of KAPP-
           3. After satisfactory review, clearance for balance LWC
           tests was granted on November 01, 2019.
              Based on review observations, some of the
           commissioning  tests (in  PHT hot condition)  were
           repeated  at KAPP-3, e.g. Passive decay heat removal
           system (PDHRS) test, PHT pressure decay  test,
           Shutdown cooling  pump hot valve-in  test,  Channel

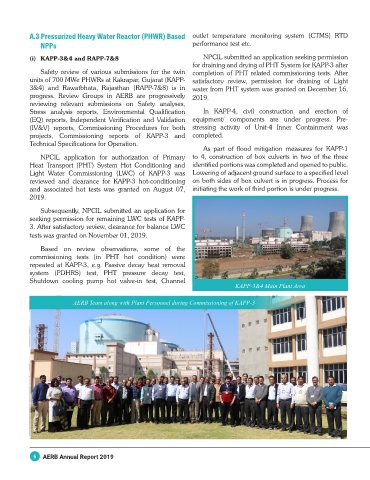

                                                                               KAPP-3&4 Main Plant Area


                         AERB Team along with Plant Personnel during Commissioning of KAPP-3
