Nuclear Power Projects- Pre-Commissioning

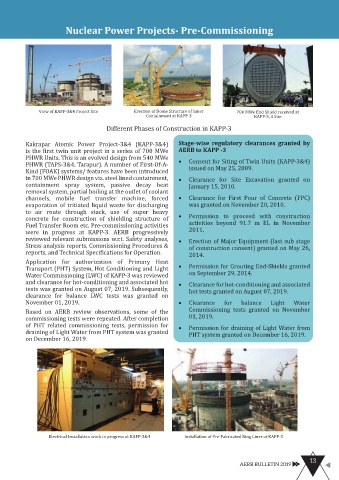

               View of KAPP-3&4 Project Site    Erection of Dome Structure of Inner   700 MWe End Shield received at
                                                    Containment at KAPP-3                 KAPP-3, 4 Site

                                      Different Phases of Construction in KAPP-3
                                                                Stage-wise  regulatory clearances granted by
          Kakrapar Atomic Power Project-3&4  (KAPP-3&4)
          is the first twin unit project in a series of 700 MWe   AERB to KAPP -3
          PHWR Units. This is an evolved design from 540 MWe
                                                                •  Consent for Siting of Twin Units (KAPP-3&4)
          PHWR (TAPS-3&4, Tarapur). A number of First-Of-A-
                                                                   issued on May 25, 2009.
          Kind (FOAK) systems/ features have been introduced
          in 700 MWe PHWR design viz. steel lined containment,   •  Clearance for Site Excavation granted on
          containment spray system, passive  decay heat            January 15, 2010.
          removal system, partial boiling at the outlet of coolant
          channels,  mobile  fuel  transfer machine, forced     •  Clearance for First  Pour  of  Concrete  (FPC)
          evaporation of tritiated liquid waste for discharging    was granted on November 20, 2010.
          to air route through stack,  use of super heavy
                                                                •  Permission  to proceed  with construction
          concrete for  construction of  shielding  structure of
                                                                   activities beyond 91.7  m EL in November
          Fuel Transfer Room etc. Pre-commissioning activities
                                                                   2011.
          were in progress  at  KAPP-3. AERB  progressively
          reviewed relevant submissions w.r.t. Safety analyses,   •  Erection of Major Equipment (last sub stage
          Stress analysis reports, Commissioning Procedures &
                                                                   of construction consent) granted on May 26,
          reports, and Technical Specifications for Operation.
                                                                   2014.
          Application  for authorization of Primary  Heat
                                                                •  Permission for Grouting End-Shields granted
          Transport (PHT) System, Hot Conditioning and Light
                                                                   on September 29, 2014.
          Water Commissioning (LWC) of KAPP-3 was reviewed
          and clearance for hot-conditioning and associated hot
                                                                •  Clearance for hot-conditioning and associated
          tests was granted on August 07, 2019. Subsequently,
                                                                   hot tests granted on August 07, 2019.
          clearance for balance  LWC tests was granted on
          November 01, 2019.                                    •  Clearance    for   balance   Light   Water
                                                                   Commissioning  tests granted on November
          Based on AERB  review observations, some  of  the
                                                                   01, 2019.
          commissioning tests were repeated. After completion
          of  PHT  related  commissioning tests, permission  for
                                                                •  Permission for draining of Light Water from
          draining of Light Water from PHT system was granted
                                                                   PHT system granted on December 16, 2019.
          on December 16, 2019.

















                  Electrical Installation work in progress at KAPP-3&4  Installation of Pre-Fabricated Ring Liner at KAPP-3


                                                                                                              13
                                                                                     AERB BULLETIN 2019
